Project & Crew Information:
- General Contractor: Cone & Graham
- Rebar Contractor: Shelby Erectors
- Union: N/A
- Crew Size: 5-person
- Shift Duration: 10-hour
- Products Used: TyBOT & IronBOT
- Deployment Dates: February 2023
β
TyBOT Performance Metrics:
- Actual Ties: 33,404 (74% Total)
- Active Production Hours: 35
- Active Tie Rate: 954 Ties/HR
- Total Equipment Hours: 70
- Active Production Rate = 50%
- Equipment Utilization Rate = 100%
β
ACR Project Scope:
- 3-Span Bridge Deck
- Bridge Deck SF: 25,868
- Width: 64β 8ββ
- Length: 400β
- Horizontal Deck Rebar: 146,361 LBS
- Total Deck Intersections: 45,010
- Tie Specs: 33% Bottom / 33% Top
β

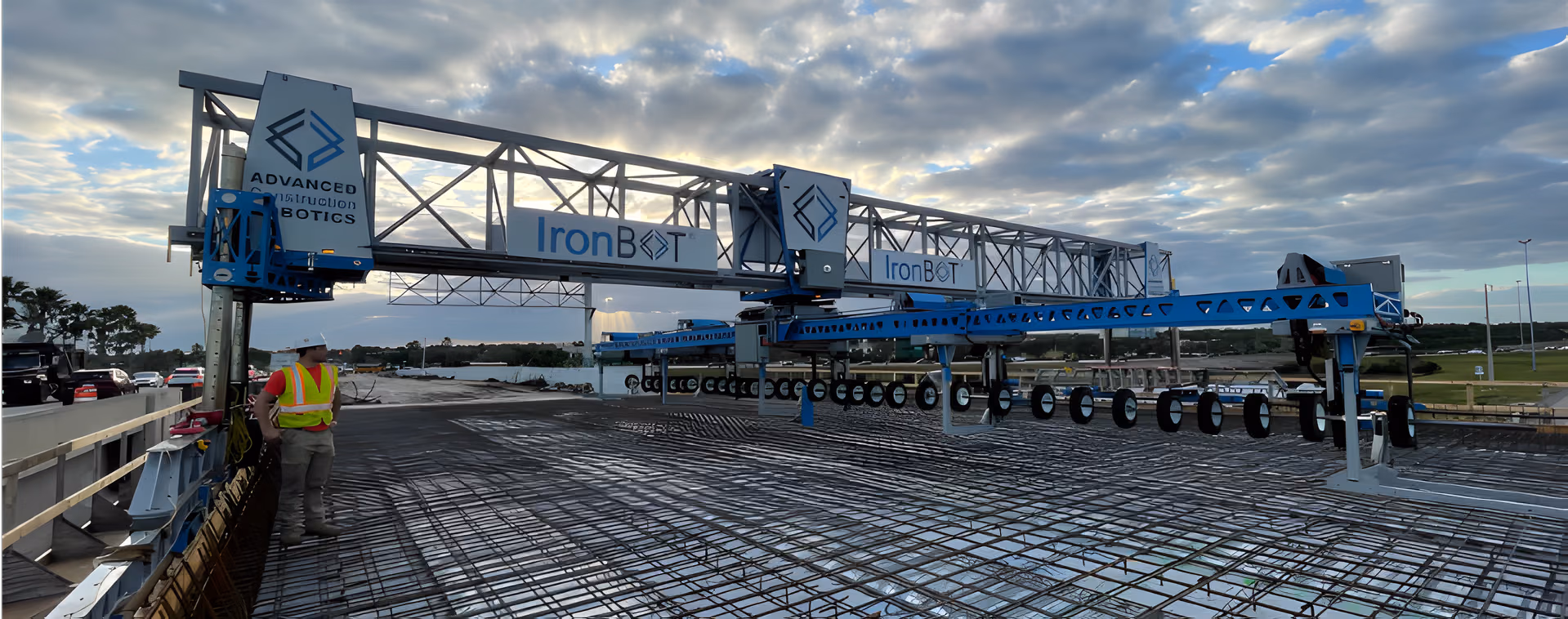

IronBOT Performance Metrics:
- Actual LBS Placed: 130,952 (90% Total)
- Active Production Hours: 24
- ActiveP lacement Rate: 5,561 LB/HR
- Total Equipment Hours: 48
- Active Production Rate = 50%
- Equipment Utilization Rate = 69%
β

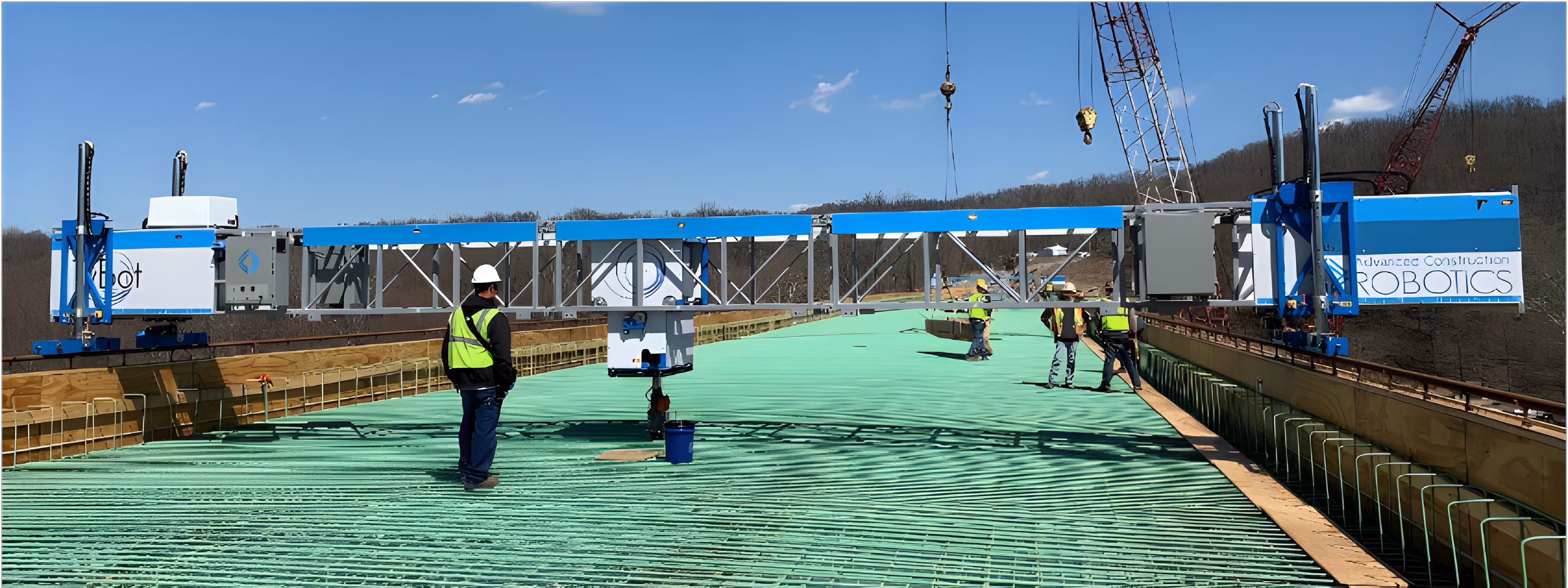

Project & Crew Information:
- General Contractor: Brayman
- Rebar Contractor: N/A (Self-Perform)
- Union: Laborers Local 1058
- Crew Size: 10-person
- Shift Duration: 10-hour
- Products Used: TyBOT
- March 2019 β April 2019
β
TyBOT Performance Metrics:
- Actual Ties: 111,645 (89% Total)
- Active Production Hours: 99
- Active Tie Rate: 1,128 Ties/HR
- Total Equipment Hours: 120
- Active Production Rate = 83%
- Equipment Utilization Rate = 92%
β
ACR Project Scope:
- 2 of 4-Span Bridge Deck
- Bridge Deck SF: 26,445
- Width:43β
- Length:6 15β
- Horizontal Deck Rebar: 269,000LBS
- Total Deck Intersections: 125,250
- Tie Specs: 50% Bottom / 100% Top
β
β

β

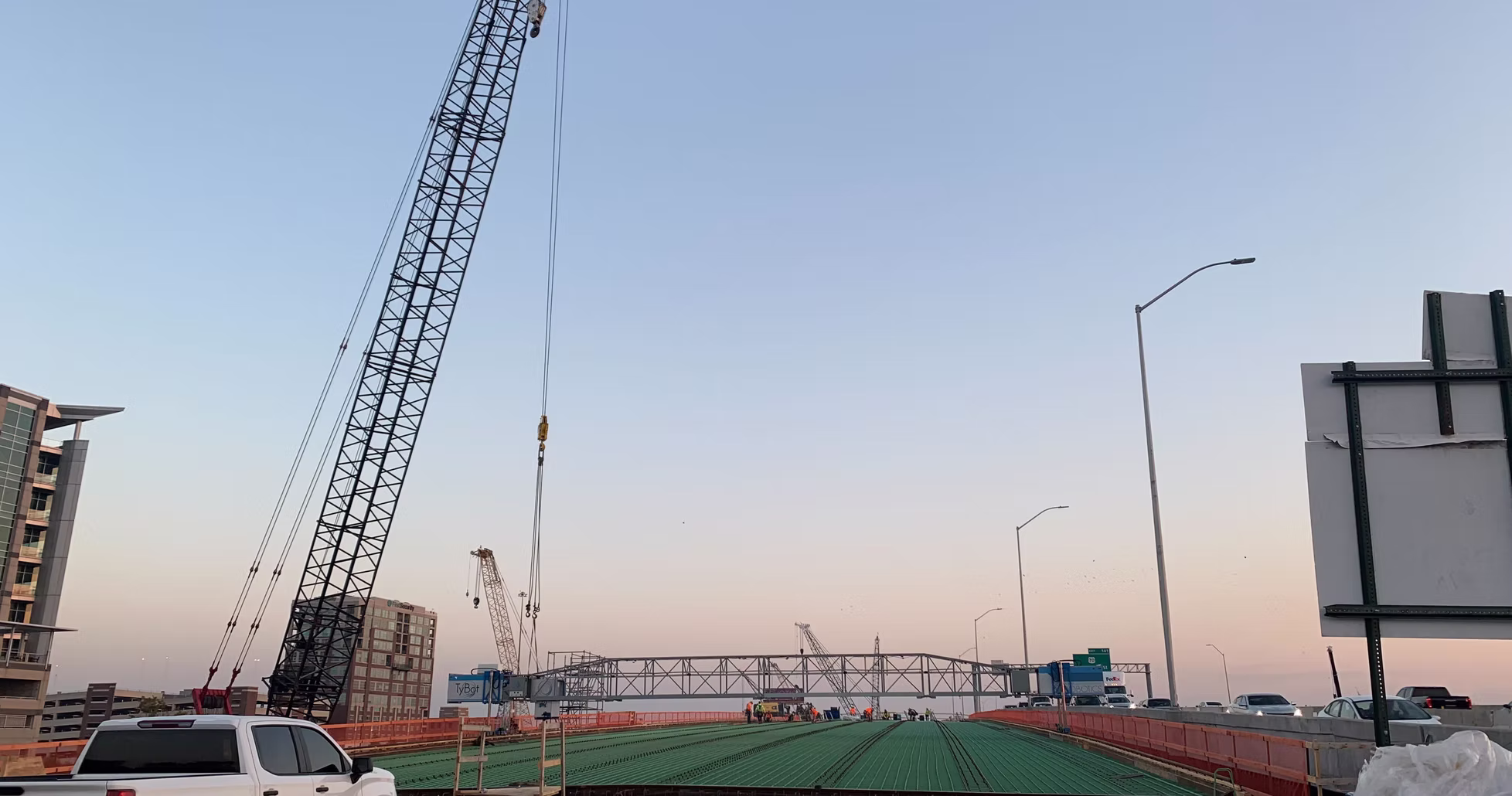

Project & Crew Information:
- General Contractor: Kiewit
- Rebar Contractor: D.T. Read Steel
- Union: Non-Union
- Crew Size: 5 person
- Shift Duration: 10 hour
- Products Used: TyBOT
- April 2024 β May 2024
β
TyBOT Performance Metrics:
- Actual Ties: 58,215 (63% Total)
- Active Production Hours: 51
- Active Tie Rate: 1,205 Ties/HR
- Total Equipment Hours: 79
- Active Production Rate = 65%
- TyBOT Shifts = 9
- Total Shifts = 9
- TyBOT Utilization Rate = 100%
β
ACR Project Scope:
- 4 of 4-Span Bridge Deck
- Bridge Deck SF: 25,154
- Width: 42'
- Length: 610β
- Horizontal Deck Rebar: 203,061 LBS
- TieSpecs: 50% Bottom / 100% Top
- Required Tied Intersections: 91,928
β

β


β
Project & Crew Information:
- General Contractor: Kiewit-Massman JV
- Rebar Contractor: D.T. Read Steel
- Union: Non-Union
- Crew Size: 10 person
- Shift Duration: 8 hour
- Products Used: TyBOT
- September 2023 β AprilΒ 2024
β
TyBOT Performance Metrics:
- Actual Ties: 669,142 (75% Total)
- Active Production Hours: 553
- ActiveTie Rate: 1,275 Ties/HR
- Total Equipment Hours: 1,167
- Active Production Rate = 57%
- TyBOT Shifts = 164
- Total Shifts = 186
- TyBOT Utilization Rate = 88%
β
ACR Project Scope:
- 12 of 18-Span Bridge Deck
- Bridge Deck SF: 252,142Β
- Width: 69' MIN β 109' MAX
- Length: 2,805β
- Horizontal Deck Rebar: 2,854,472 LBS
- TieSpecs: 50% Bottom / 50% Top
- (2 spans 100% Top)
- Required Tied Intersections: 887,387
β

β
